Conservation Works

Fox Tor Stone Alignment

July 2023

About Fox Tor Stone Alignment

This monument is a prehistoric stone alignment with two outlying stones, situated on East Moor on Bodmin Moor. The monument is one of many local, broadly contemporary ceremonial and funerary monuments including a large, embanked platform cairn, a second stone alignment on the periphery of another platform cairn and a ritual spaced-stone enclosure.

Containing 30 visible stones, the monument is experienced as a single, almost straight, row of stones extending 614m across a valley to the southern lower slope of Fox Tor making it the longest in Cornwall. Gaps do occur where stones have been removed or have fallen and lie buried beneath the turf; these gaps are likely to contain the sockets of the intervening slabs, their packing stones and the fallen stones themselves where they have not been removed.

Why were the repairs needed?

This stone alignment is listed on Historic England’s at-risk register with the main threat resulting from livestock erosion. Cattle, ponies and sheep rub against the stones and erode the ground surrounding the base which exposes the packing stones, and this ultimately leads to destabilisation. Hollows created by the erosion are then filled with rainwater making them even more vulnerable to toppling. A survey carried out in 2021 found that the hollows, which at the time were filled with water, were up to 60cm deep. Furthermore, the site is under threat from overgrown gorse which obscures the alignment resulting in the site being difficult to find and is therefore underappreciated.

What repairs were carried out?

Infilling the eroded hollows:

  1. Preliminary recording of eroded areas
  2. Silt and mud from the bottom of the hollows was cleared down to the firm subsoil, to provide a solid base to build up from.
  3. The edges of the hollows were then cut back to vertical, to form a solid edge up against which filling materials were firmly wedged.
  4. A layer of white sand was placed in the base of the hollows, to provide an archaeologically distinct layer.
  5. A thin layer of light orange-brown, clean subsoil was spread over the top of the white sand, to bed the next layer of stones in.
  6. The hole was then filled with blocks of mostly weathered granite, wedged as closely together as possible. These blocks were kept below ground surface level to prevent them from being exposed too quickly, should the repair work subsequently be worn away.
  7. The gaps between the stones were then filled with subsoil and compacted.
  8. A layer of subsoil was then spread over the stones and thoroughly compacted down; this layer was brought up to approximately ground level with the centre slightly raised to create a domed surface to drain water away from the stone.
  9. A 10cm layer of topsoil and local horse dung was spread across the subsoil to enrich the soil to help the final layer of turf to grow.
  10. The infilled hollow was then covered with grass turfs which were smoothly blended with edge of the infilled area, with any gaps filled with topsoil.
  11. As a final protection, gorse was cut from the surrounding moor and tied around the stones to prevent livestock from trampling on the repaired area for as long as possible, and thereby give the turf a chance to consolidate.

Re-erecting of standing stones:

  1. A dry-stone surround of local granite was placed in the sides of the original socket cut to create a solid foundation for the stone.
  2. A layer of white sand was spread in the base of the cut and then covered with subsoil, this made sure any future excavators know that there has been previous intervention.
  3. The stones were then raised using digger straps and lowered into the new cut socket.
  4. The surrounding hollow was then infilled using the method above.

What’s Next?

Monitoring of the site is key to the sites long-term survival. Volunteers will continue to monitor the condition of the repairs and stone alignment as a whole in the future, feeding back any concerns or issues to the Historic England Heritage at Risk Officer. Furthermore, the site will have accessible digital interpretation on our website including an annotated still drone image. There will be no on-site interpretation as this detract from the natural beauty of the surrounding area.

Emblance Downs Stone Circle

August 2023

About Emblance Downs Stone Circles

This monument includes two stone circles situated on Emblance Downs. They are positioned close to one another at approximately 2.5m apart.

The western circle survives as a ring of stones, including five uprights and two recumbent stones with three possible sockets missing their original stones and would have had a diameter of approximately 23m. The stones appear to have been irregularly spaced (between 4.5m to 5m apart) and originally numbered about 15. Two fallen and displaced stones lie near the centre of the circle with the stones varying in height from 0.3-1.2m high. Close to the centre of the circle is a low mound measuring 4.5m long by 3m wide and 0.4m high.

The eastern circle survives as two upright and four fallen stones, one of which appears to have been displaced from the circle and now lies 2m to the south. The diameter is calculated at approximately 23.25m.

Why were the repairs needed?

Historic England’s Heritage at Risk Register lists the principal threat to the stone circles as livestock erosion resulting in hollows to form around the stones which now frequently flood so severely that channels have formed through the entire monument. Several of the stones have fallen, most notably in the eastern circle, to the extent that few would recognise that it anything other than a collection of moor stones. The water filled hollows around the few remaining upright stones make them increasingly vulnerable to toppling and threatens the sites long-term survival.

What repairs were carried out?

Infilling the eroded hollows:

  1. Preliminary recording of eroded areas
  2. Silt and mud from the bottom of the hollows was cleared down to the firm subsoil, to provide a solid base to build up from.
  3. The edges of the hollows were then cut back to vertical, to form a solid edge up against which filling materials were firmly wedged.
  4. A layer of white sand was placed in the base of the hollows, to provide an archaeologically distinct layer.
  5. A thin layer of light orange-brown, clean subsoil was spread over the top of the white sand, to bed the next layer of stones in.
  6. The hole was then filled with blocks of mostly weathered granite, wedged as closely together as possible. These blocks were kept below ground surface level to prevent them from being exposed too quickly, should the repair work subsequently be worn away.
  7. The gaps between the stones were then filled with subsoil and compacted.
  8. A layer of subsoil was then spread over the stones and thoroughly compacted down; this layer was brought up to approximately ground level with the centre slightly raised to create a domed surface to drain water away from the stone.
  9. A 10cm layer of topsoil and local horse dung was spread across the subsoil to enrich the soil to help the final layer of turf to grow.
  10. The infilled hollow was then covered with grass turfs which were smoothly blended with edge of the infilled area, with any gaps filled with topsoil.
  11. As a final protection, gorse was cut from the surrounding moor and tied around the stones to prevent livestock from trampling on the repaired area for as long as possible, and thereby give the turf a chance to consolidate.

Re-erecting of standing stones:

  • A dry-stone surround of local granite was placed in the sides of the original socket cut to create a solid foundation for the stone.
  • A layer of white sand was spread in the base of the cut and then covered with subsoil, this made sure any future excavators know that there has been previous intervention.
  • The stones were then raised using digger straps and lowered into the new cut socket.
  • The surrounding hollow was then infilled using the method above.

What’s Next?

Monitoring of the site is key to the sites long-term survival. Volunteers will continue to monitor the condition of the repairs and stone alignment as a whole in the future, feeding back any concerns or issues to the Historic England Heritage at Risk Officer. Furthermore, the site will have accessible digital interpretation on our website including an annotated still drone image. There will be no on-site interpretation as this detract from the natural beauty of the surrounding area.

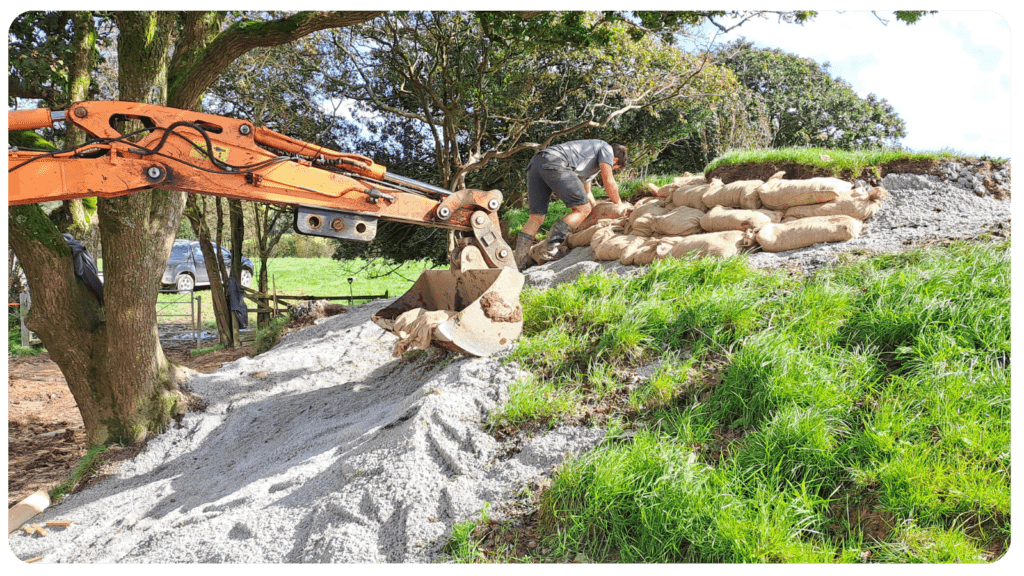

Conservation Repairs at Castle Dore

September 2023

About Castle Dore

Castle Dore is a small multivallate hillfort, surviving as a roughly circular central area defined by a well-constructed inner rampart and ditch. A partial excavation of the hillfort interior by CA Raleigh-Radford in 1936-7 provided a 5th – 4th centuries BC construction date (based on ceramic evidence), followed by a period of abandonment after which the entrance area was remodelled (probably in the 4th – 3rd centuries BC).

The interior contained a number of four- to six-post structures and the remains of some round houses, defined by stake holes indicating a complex building sequence with frequent replacements of structures over a prolonged period. Two oval structures may also represent Romano-British or later occupation, although the pottery assemblage seems to indicate abandonment before the Roman period.

Excavated evidence also revealed the presence of finds relating to the battle between Charles I and the Earl of Essex, fought at Castle Dore during the Civil War when in 1644 Parliamentarian forces retreated into the earthworks and held the position until dark. As a result, Castle Dore is a registered battlefield as well as a scheduled monument.

Why were the repairs needed?

Through the Monumental Improvement project, the Cornwall Archaeological Unit were commissioned to carried out a programme of work to help assess the hillfort’s condition and develop management proposals for the site. This included a desktop assessment and detailed earthwork survey. As the site is currently listed on the Heritage at Risk Register as a result of erosion caused by stock, these management proposals were largely focused around fixing the eroded areas with the aim of securing the sites removal from the At Risk Register.

What repairs were carried out?

  1. Preliminary recording of the eroded areas
  2. Lift any turf growing in the eroded hollow and reserve for use in re turfing the repaired areas
  3. Trowel clean and record the eroded surface
  4. Spread a marker layer of white sand over the base of the erosion scar
  5. If required, insert timber revetments into the erosion scar to help retain filling material
  6. Loosely fill hessian sandbags with subsoil-type material
  7. Lay subsoil-filled sandbags over the eroded areas, packing closely together and compacting well to produce a firm surface
  8. Fill the eroded hollows to a level which matches reasonably well with the level of the un-eroded parts of the rampart to either side
  9. Cover sandbags with a thin layer of topsoil
  10. Replace any reserved turf over the repaired areas and sow an appropriate grass seed mix over the rest of the surface
  11. Lay hessian netting, pinned down using wooden stakes, over the repaired areas to protect them from the elements

In addition, the team also removed some small and dead trees from the monument which were affecting the largest area of erosion, and we also re-sited the interpretation panel and water trough in order to encourage cattle away from the monument.

What’s Next?

The permissive access to the scheduled monument is currently closed in order to allow the erosion repairs to settle in and the newly re-seeded grass to grow. Access will be reopened in 2024.

A special thank you to the landowners and tenants of the monuments who have worked with the project and Historic England to help protect the sites for future generations to enjoy.

Thank you also to our team of volunteers who helped with the conservation works!

top border
